How to Reduce Dust During Data Center Construction
For data center construction, contamination control is critical to keeping the schedule on track. Fine dust generated during cutting, drilling, and finish-out can compromise required ISO cleanroom standards and settle on sensitive MEP and IT equipment. Once contamination enters these environments, removing it can be costly and disruptive. Effective dust control needs to be considered from the outset and maintained throughout the construction schedule.
This article looks at why dust control matters on a data center build, where the dust actually comes from, and the practical methods that keep it in check, from site sequencing to physical containment screening. Whether you're closing in a new-build shell or working alongside a live data center, the focus is on keeping contamination out of the spaces that can't tolerate it.
Why dust control matters in data center construction
In most buildings, construction dust is a nuisance, but in a data center it's a threat to the equipment the facility is built around. Servers rely on heat sinks, fans, and airflow to shed heat, and particulate matter degrades every one of them, forcing cooling systems to work harder for less. Dust that settles during the build affects performance long after turnover.
There's a compliance dimension, too. Data centers are typically required to meet ISO 14644-1 Class 7 or Class 8 cleanroom standards before a space can be signed off, and those thresholds are unforgiving. A white space that looks clean to the eye can still fail a particle count.
The real cost, though, is timing. Contamination that goes unmanaged during the build surfaces at the final clean stage, when the schedule is at its tightest and there's little to no room to react. What could have been contained early becomes rework: re-cleaning and re-testing that increase the pressure on the turnover date. Dust control matters because it protects the equipment, the certification, and the schedule.
Prevention vs. cleaning: two different approaches
It's worth being clear about a distinction the industry often blurs. Cleaning removes dust that has already accumulated. Prevention stops it from spreading or settling in the first place. They're not the same job, and they don't happen at the same point in the schedule.
A large share of the published guidance on data center dust comes from specialty cleaning contractors, and it's written from their perspective, focusing on the clean-up stage once construction is largely done and the particle count has to be brought down to standard. That advice is valuable, but it addresses the last line of defense, not the first.
Prevention is the complementary discipline that comes earlier: sequencing work so dusty trades don't contaminate finished zones, controlling movement between dirty and clean areas, and physically containing the messiest processes so their debris never reaches sensitive spaces at all. Done well, prevention doesn't replace the final clean, but it dramatically reduces how much cleaning is needed and how much risk rides on it.
Common sources of dust on data center construction sites
You can't contain what you haven't accounted for, so it helps to know where the dust on a data center site actually originates. A handful of activities generate the bulk of it:
- Concrete cutting, drilling, and curing. Core drilling, channel cutting, and saw cutting throw off fine silica dust, and curing slabs continue to shed particulates as they dry.
- Drywall and cladding installation. Cutting and sanding drywall produces a light, pervasive dust that travels easily and settles everywhere.
- MEP and ductwork installation. Mechanical, electrical, and plumbing work, and ductwork runs in particular, disturb and distribute dust through the very cavities that air will later move through.
- Foot traffic between exterior and interior areas. Dirt and grit tracked in on boots and wheels is a constant, low-level source that's easy to underestimate.
- General trade activity in adjacent or overlapping zones. On an active project, several trades work in parallel, and dust generated in one area readily migrates into another that's supposed to be clean.
The pattern is clear: dust rarely stays where it's made. Left unmanaged, it drifts across work boundaries and into the zones least able to tolerate it.
Prevention methods for reducing dust during construction
Reducing dust is less about any single measure than about layering several so they reinforce one another. A practical prevention strategy on a data center build usually draws on all of the following:
- Plan site logistics. Establish hard-surface walkways and defined haul routes so dirt isn't tracked across the site. Well-planned movement keeps grit out of the building before it becomes airborne.
- Sequence the work. Order trades to minimize contamination. For instance, complete overhead MEP and ductwork before raised floors go in, so dust from the messy work above never settles into finished flooring below.
- Control entry and exit. Install walk-off mats and set up controlled access points into sensitive zones, so people and materials pass through a managed boundary rather than an open one.
- Manage air pressure. Maintain positive air pressure in critical spaces to push contamination out rather than let it drift in, and change filters regularly so the system keeps performing as intended.
- Restrict access during dusty phases. Limit who and what enters critical areas while the dustiest work is underway. Fewer movements through a clean zone mean fewer opportunities for contamination.
- Contain the source. Use physical screening to separate dusty processes from finish-out and live areas entirely. This is the most direct method because it stops dust at the point where it's generated, rather than managing it once it's loose.
Sequencing and logistics reduce how much dust is created and moved, while containment deals with what's left. Together, they take the pressure off the final clean and protect the project's most sensitive spaces throughout the build.
Benefits of dust containment screens
Of all the prevention measures available, physical containment does the most decisive work, because it draws a hard boundary rather than simply managing risk on either side of an open one. A dust containment screen physically separates the dusty end of construction from the finish-out zones and server installation areas that can't tolerate contamination.

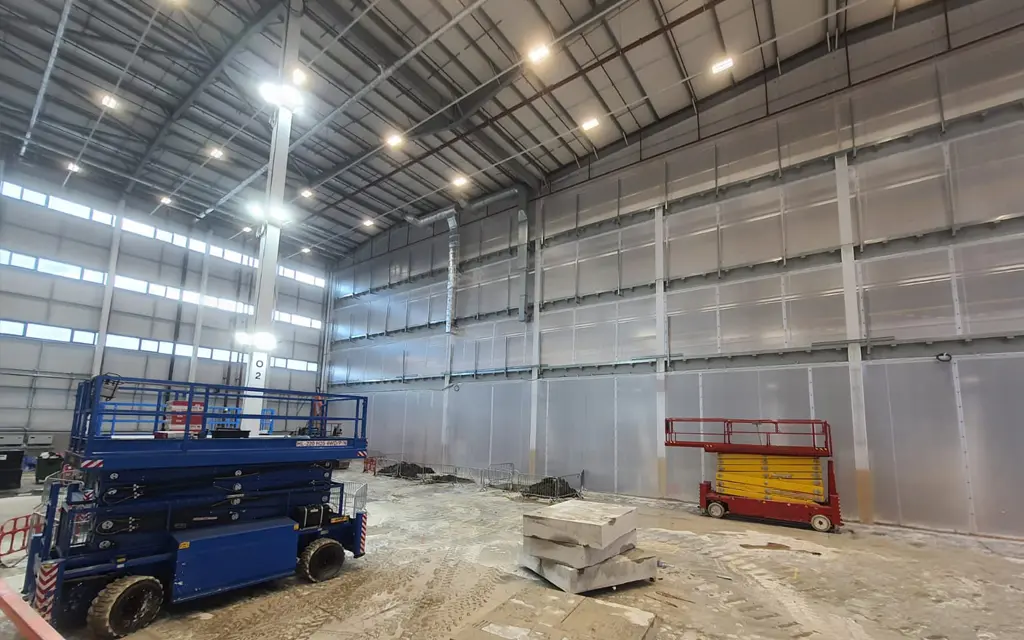

Flexiscreen is engineered for exactly this. Suspended floor to ceiling from the building's existing structural steel, it forms an over 99% dust-tight seal around ducts, pipes, steel members, and at ceiling level (the awkward junctions where contamination usually escapes). It can be specified to meet ISO Class 7 cleanroom standards where the environment demands it, and antimicrobial fabric options extend that protection into the most sensitive areas.
By keeping a completed zone sealed off from the work next door, containment lets that zone be commissioned and turned over while construction continues elsewhere. This enables early phased turnover rather than a single, hold-everything clean at the end. Thanks to the system's modular design, it's reusable and reconfigurable: the same screening can seal one area in an early phase, then be relocated and rebuilt to contain a different zone as the project moves forward.

Protecting live data centers
The hardest dust control challenge isn't a new build. It's expanding or renovating next to a data hall that's already running. Contamination in this environment isn't just a quality risk to finished work; it's a direct threat to live, revenue-generating equipment just feet away. A single breach of construction dust into the operational environment can jeopardize the active servers that keep the facility online.
The answer is complete separation. Sealed boundaries wall the work off from the live space, and controlled access points govern every movement in and out, so the operational hall stays isolated from the dust generated alongside it. Construction proceeds behind the screen, and the data center keeps running as though nothing were happening next door.
During a renovation beside a fully operational data hall, sealed Flexiscreen containment held the boundary between active work and the live environment throughout. No dust got into the running space, and there was no disruption to uptime while the project progressed.
Choosing the right dust control approach for your project
The right approach depends on the project in front of you. Before you specify a solution, work through these questions:
- New build or live facility? Is the area a new-build shell, or a live, operational space where contamination would threaten running equipment?
- Which ISO standard? Does the project need to meet a specific cleanroom classification, such as ISO Class 7 or 8, before turnover?
- Would phased turnover help? Are there completed zones that, if protected from ongoing work, could be signed off and released early to ease the schedule?
- Design out or contain? How much of the dust risk can be engineered out through sequencing and logistics, and how much needs physical containment to manage?
- Reuse across phases? Will containment need to be relocated or reconfigured as the work moves through the site?
The answers rarely point to a single measure. Most projects combine sequencing, access control, and containment in the right proportions. If you're not sure where the balance lies for your project, read our data center screening solutions guide or get in touch, and Westgate Global's screening experts can assess your site and specify an approach that fits.
FAQs
What's the difference between dust prevention and dust cleaning on a construction site?
Cleaning removes dust that has already accumulated; prevention stops it from spreading or settling in the first place. Cleaning is the final-stage discipline that brings a space up to standard before turnover, while prevention runs throughout the build, using access control and containment to reduce how much dust is ever released. The two work together: strong prevention means far less to clean and less risk of contaminated surfaces late in the project.
What ISO cleanroom standard do data centers typically need to meet?
Data centers are generally required to meet ISO 14644-1 Class 7 or Class 8 before a space can be turned over. Which one applies depends on the facility and the zone, but both are strict enough that a white space can look clean and still fail a particle count. That's why dust has to be managed during the build, not just cleaned up at the end.
Can dust containment screens help achieve early phased turnover?
Yes. By sealing a completed zone off from dusty work elsewhere on site, containment keeps that zone at standard while construction continues around it. It can then be signed off and released to the owner early, rather than waiting for a single turnover once the whole project is finished. Finished space becomes usable sooner.
How is a live or operational data hall protected from nearby construction dust?
Through complete physical separation. Sealed screening walls the construction work off from the live environment, and controlled access points manage every movement between the two, so dust generated by the build can't migrate into the operational space. As a result, expansion or renovation can happen just feet from running servers without putting them at risk.
Can dust containment screening be reused across multiple project phases?
Yes. Modular screening such as Flexiscreen is designed to be dismantled, relocated, and reconfigured as the project evolves, containing one area in an early phase and then protecting a different zone later. A single system adapts across the whole project rather than being torn out and replaced each time the work moves on.
Conclusion
On a data center build, dust is never just dust. It's a risk to sensitive equipment and to cleanroom certification. Managing it well means treating prevention as the first line of defense: sequencing work to create less dust, controlling movement between dirty and clean areas, and physically containing the messiest processes so contamination never reaches the spaces that can't tolerate it.
